Baltimore County Public Schools told the planning board subcommittee on Feb. 2 that its FY27 capital improvement program (CIP) continues to follow recommendations from the district's multiyear improvement plan, while funding constraints risk delaying construction and renovation projects.
BCPS Chief Operating Officer Jess Grimm said priorities remain aligned to the myIPASS recommendations and infrastructure work intended to support student achievement, but that rising construction costs and limited new county funding have constrained what the district can advance. "Our priorities within the capital improvement program continue to focus on recommendations from the multiyear improvement plan for all schools," Grimm said.
Grimm listed projects the district has placed on the state and county funding requests. He said four items are currently requested only from the state'including partial construction funding for Delaney High School, remaining construction funds for Scotts Branch Elementary, and additional planning and design for Patapsco High and the Northwest CTE Center'and warned that projects not receiving state funding at final approval would be delayed at least a year. Grimm also said FY27 is largely a "nonfunding year" for new county money and the district must rely on funds approved in last year's referendum to complete listed projects.
The presentation noted a mix of systemwide infrastructure needs and capacity projects. Grimm described BCPS as having one of the oldest building inventories in the state and said systemic work (boilers, chillers, electrical and plumbing) often takes precedence over capacity projects when failures occur. He told the committee that the original myIPASS estimate of about $4 billion in capital needs has grown and, accounting for elapsed time and construction inflation, the district now estimates costs could be roughly double that figure.

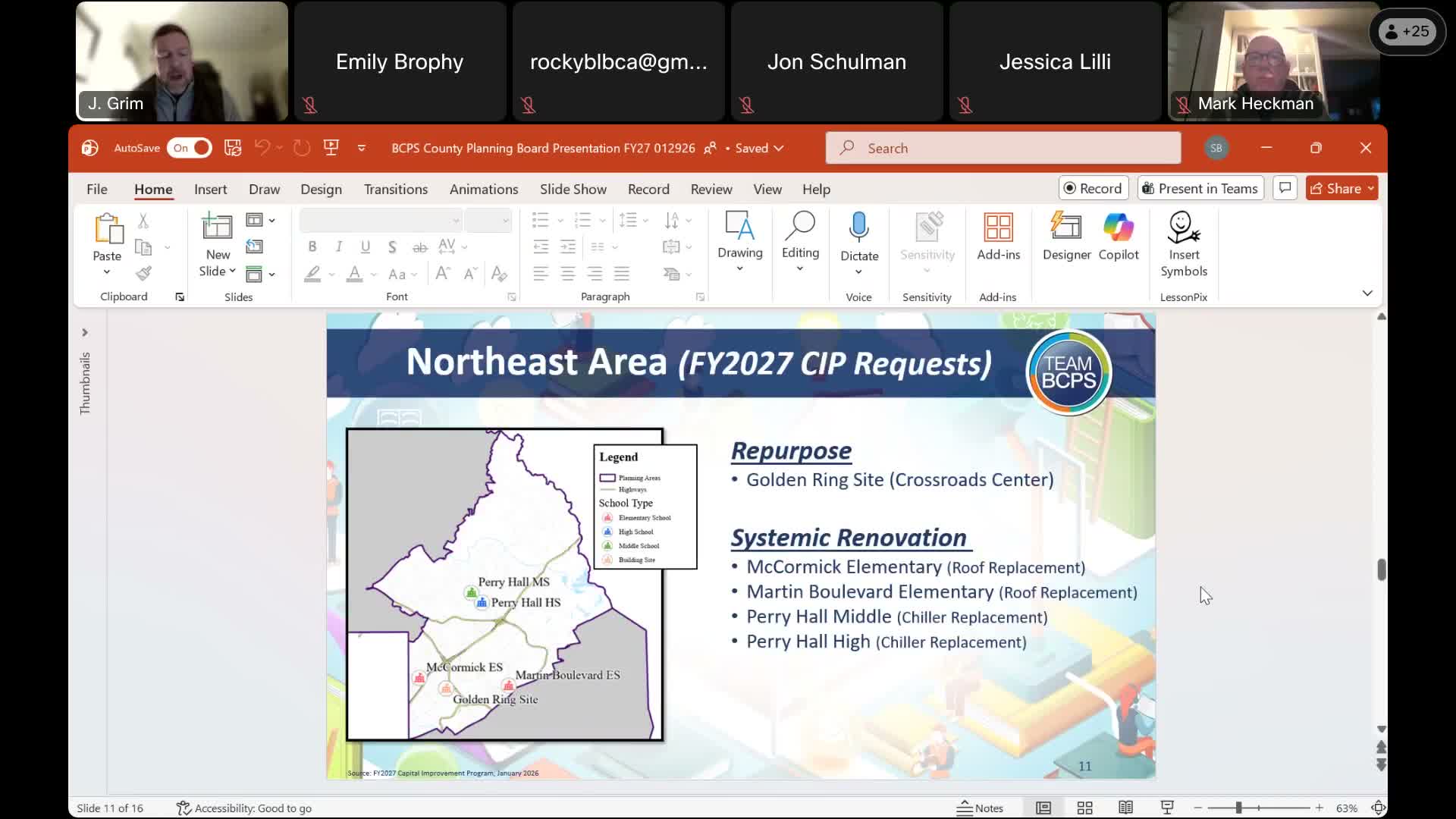

On specific items, Grimm said the former Golden Ring Middle School site is proposed for repurposing as the Crossroads Center, which would shift an existing leased alternative-education center into a district-owned facility. Grimm said Crossroads'which serves students from the Central, Northeast and Southeast areas'would occupy a smaller enrollment at Golden Ring (about a 250-student capacity) and the project is included on the county request only. He said the district would target improvements to match the smaller student population and expects the site to open in 2027 if funded. "We would think it's a long-term move," Grimm said of relocating Crossroads to Golden Ring.
Grimm also described a study for Sparrows Point that concluded replacement of both the middle and high schools would be more cost-effective than renovating existing buildings; however, he said the Sparrows Point replacement is on hold because funding is not yet secured. He told members that three high-school replacement projects are currently under construction and that those large projects significantly drive costs in the short term.
The district highlighted sustainability work, saying Deer Park Elementary is being built as the county's first net-zero school and that Delaney and Towson high schools are being built to Green Globes 2 standards; Delaney is expected to have solar panels covering roughly 40% of its roof. Grimm also confirmed that while "classrooms and most learning spaces" are air conditioned in BCPS schools, some auxiliary spaces (gyms, kitchens and a handful of cafeterias) are not.
Board members pressed presenters on geographic prioritization, asking how BCPS balances systemic repairs against capacity projects and how the district addresses overcrowding on the East Side. Grimm said decisions rely on facility-condition assessments, the priority order established in myIPASS, site studies and the availability of state and county funding.
The subcommittee did not take any votes. Chair Emily Brophy said the subcommittee will meet again on Feb. 15 to hear staff recommendations on the CIP.
