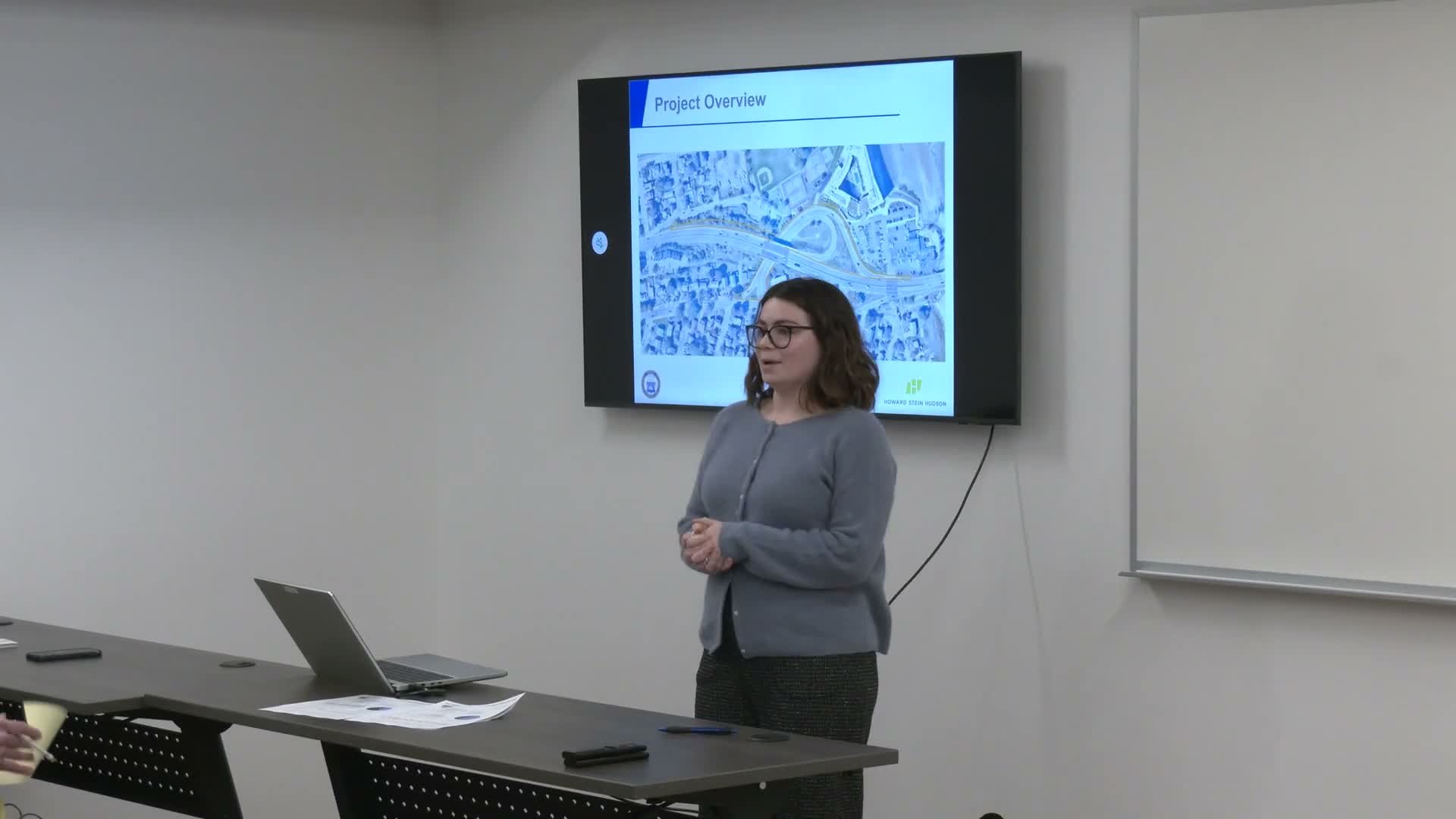

Revere City officials and their engineering team described the scope, schedule and community impacts of a proposed roundabout and related Gibson Park access work at a crowded neighborhood meeting.
Christina Malcom of engineering firm Howard Stein Hudson, who led the presentation, said the roundabout work is broken into five phases: Phase 1a (new on‑ramp, slip‑lane demolition and northern roundabout construction) about 32 weeks; Phase 1b (median demolition and sidewalk work) about 3 weeks; Phase 2 (new off‑ramp and a shared‑use path) about 31 weeks; Phase 3 (the leg to Gibson Point, demolition of the existing off‑ramp and splitter islands) about 13 weeks; Phase 4 (inner circle construction and driveway reconstruction) about 4 weeks; and Phase 5 (sidewalk connection to Gibson Park and demolition under the bridge) about 7 weeks. Malcom said the estimated project completion date is November 2027.
Why it matters: the project reshapes how drivers and pedestrians enter the neighborhood from Route 1A and creates a new access route to Gibson Park. City staff and the contractor told residents they intend to keep pedestrian routes open during construction and to publish look‑ahead notices: two‑week notices for typical impacts and one‑month notices for planned overnight ramp closures.
Key schedule, closures and work hours
- Malcom and contractor staff said crews have begun mobilization and preliminary clearing. Overnight closures of specific ramps will be limited, they said, to 9:00 p.m.–5:00 a.m. and will occur only as needed for critical tie‑ins. The team estimated most work will be daytime shifts (generally 7:00–3:30 p.m. or 7:30–3:00 p.m.).
- The contractor said the project is primarily a daytime job and that only limited night tie‑ins are expected; one presenter estimated those tie‑ins would represent roughly 10% of the connecting work, and staff said they currently expect about three nights requiring full ramp closures for tie‑ins.
Community concerns: pedestrian safety, noise and trucks
Residents repeatedly pressed officials about pedestrian safety for children and older residents walking to Gibson Park, asking for push‑button flashing beacons, signal buttons, stop signs or other measures to make crosswalks more protective. Officials said they can explore flashing beacons and additional pedestrian features but that MassDOT — which has right‑of‑way authority on Route 1A projects — must approve certain changes. Malcom said the roundabout is designed to slow vehicle speeds and includes refuge islands and sight‑line improvements; she emphasized the team used a “large design vehicle” to review turning radii and that the final geometry is intended to accommodate larger vehicles.
Noise and night work: residents asked how often and how loud overnight work will be. Presenters acknowledged there will be some night work for critical tie‑ins but said the contractor’s goal is to minimize night hours and disturbances. The project team said they will work with residents, the councilor and the mayor’s office to limit impacts and share contact information for immediate concerns.
Property impacts and construction limits
Residents questioned a GIS overlay that showed property lines; presenters repeatedly stressed that the overlay is illustrative, not a survey, and that only areas highlighted in green on the plan are within the project limits. Officials said there are no planned takings shown on the project overlay presented that night.
Gibson Park and Garden
Malcom said the Gibson Park renovation contract was awarded to Heimlich Landscaping and that, after a period when state earmark funds were frozen, Representative Turco helped unlock money so the park project could proceed. The park renovation is expected to have a construction cycle of roughly 18 months once a contractor is on site. The Gibson Park access road is a separate project; the team said permitting (including a Chapter 91 license) is under way and that advertising and construction are anticipated in 2027.
The city told gardeners the community garden will be relocated (the intent is to keep a garden available for the next growing season and to move it before the following season), and staff committed to a pre‑construction community meeting at the park to review bench relocations, garden placement and other details with affected families.
Cost and coordination
When asked, a presenter said the roundabout project’s cost is roughly $8,000,000; several attendees expressed skepticism about the estimate. Presenters also noted coordination with other nearby work (MWRA repairs and a future General Edward Bridge project) and said those other projects are at different phases and not directly coordinated for construction timing.
Next steps and contact information
The presenters urged residents to sign up for the project mailing list for look‑ahead notices and said project updates and detailed plans will be posted on the city website. They also said Mass 511 and City of Revere 311 will carry detour information for scheduled ramp closures. Staff remained after the meeting to speak individually with residents.
What remains unresolved: residents asked for firm commitments on push‑button beacons, final decisions on crosswalk controls and precise night‑work schedules. Officials said they will pursue those questions with MassDOT and report back through the mailing list and future community meetings.
